Construction Projects

Drilling for Water Well #3
Project ID: Drinking Water Well #3

Project Type: Capital Improvement Project

Project Status: Active

Project Start Date: Spring 2023

Site Location: Rees St.

Funding Source: American Rescue Plan Act (ARPA)

Project Update:

  • April 2023: Well drilled.

  • May 2023: Casing installed.

  • June 2023: Flow testing being conducted.

  • July 2023: Well house and supportive equipment design is underway with construction anticipated over winter. Well casing shown in second photo. Project anticipated to be completed in 2026.

  • April 2024: Generator for Water Well delivered. Shown in third photo.

Project Description: The project will expand the water system capacity to serve both new and existing customers, improve reliability with new equipment, reduce the burden on operators with fully automated systems, improve energy and water efficiency and provide redundancy with the addition of the second well. The benefit to the community includes a modern, reliable, safe and secure drinking water system that will support population growth and economic development for the next 20 years.

Well Casing
Generator
Project ID: Water Service Line Replacement Project


Project Type: City of Donald Construction

Project Description: About 150 water service connections constructed with copper material have been identified. These lines are prone to corrosion and pitting in the soil, which leads to water leaks. To proactively address the problem and improve the reliability of the water system, the City will be replacing these lines.

Project Status: Phase 1 of the project began in the Country Oaks Estates neighborhood. Work in this area will allow the City to begin addressing the most immediate concerns while establishing an efficient process for replacing the remaining service lines throughout the community.

Project Start Date: March 30, 2026

​

Rendering of Donald Cafe
Project ID: Donald Cafe Redevelopment Project

Project Type: Private Commercial Construction

Project Description:

Demolition of existing structure, and redevelopment of restaurant, deck and apartment dwelling with an estimated completion summer 2026.

Project Status: Permits have been issued and foundation work has commenced.

Project Start Date: August 2025

Site Location: Main St. Donald, OR

Project Update:

  • January 2025: Project plans received.

  • August 2025: Permits issued and foundation work began.

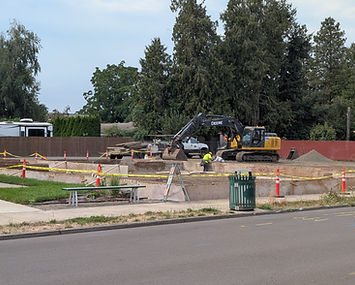

Donald Cafe Foundation
Donald Cafe framed
Project ID: Harvest Gardens Agrihood
Harvest Gardens homes

Applicant: GRC Landholdings, LLC

Project Type: Land Use

Project Status: Active

Project Start Date: 2021

Site Location: Southeast corner of Donald, OR

Project Update:

  • June 2023: Phase 1 Home construction has commenced.

  • July 2023: Phase 2 Plan Review being finalized.

  • March 2024: Phase 2 Home construction has commenced.

  • 2024 Phase 1 and 2 construction completed.

Project Description: Harvest Gardens is a planned community and working farm that will be located on the SE corner of Donald's City limits. A variety of lot sizes and housing types are provided that are intended to accommodate a mix of home sizes and plans, appealing to a broad range of future residents and the local workforce. Eleven phases have been approved.

Project Docs:

Harvest gardens homes
Aerial view of Harvest Gardens
Pacific Lumber site

Project ID: Pacific Lumber: COMPLETED

Project Type: Private Project - Industrial Construction

Project Status: Active

Project Start Date: 2023

Site Location: 21270 Butteville Rd.

Project Contractor: Endres Northwest Inc.

Project Update:

  • April 2023: Preliminary grading in process. Working on finalizing building permits for construction.

  • October 2024: Certificate of Occupancy issued. Fully opperational.

Project Description: Consolidation of 2 lots into 1 Industrial lot. Construction of 110,000sq./ft. speculative Industrial building with office space and loading docks.

Freeway interchange
ODOT logo
Exit 278 Phase 2 diagram
ODOT: I-5 Aurora-Donald Interchange - Building the Diverging Diamond

ODOT Project Number: 22505

Project Schedule:

  • Design: 2023

  • Estimated Construction: 2024-2027

Site Location: I-5, Aurora-Donald Interchange, Exit 278

Project Manager: ODOT Transportation Project Manager, Paul Welch

Cost & Funding: Total estimated cost to construct: $62.5 million

Project Description: Approximately 32,000 vehicles use Exit 278 Aurora-Donald or travel past the ramps entering and exiting I-5. The volume of traffic, proximity of roads and access points and visibility issues cause congesting and safety concerns around the interchange. Phase 1A addressed some of these issues.

​

Phase 2 constructs the full diverging diamond interchange. This addresses the capacity issues by building an interchange that will work for years to come. The estimated schedule for construction is 2024-2027.

​

Click the button below to be redirected to ODOT's project information page.

Official Website of the City of Donald



City Hall: 10710 Main St. NE ~ PO Box 388, Donald, OR 97020

Phone: 503-678-5543     Fax: 503-678-2750
